What is HTM 03 01 and why does it matter?
HTM 03 01 is the UK’s authoritative technical standard for the design, installation, operation, and maintenance of ventilation systems in healthcare premises. Published by the Department of Health and mandated by NHS England, it defines minimum requirements for performance, hygiene, reliability, and energy efficiency to ensure that indoor air quality supports clinical safety and patient wellbeing.
Unlike generic HVAC design codes, HTM 03 01 treats ventilation not as commodity engineering but as clinical infrastructure. It governs every aspect of airflow, pressure regimes, filtration, noise control, validation, and lifecycle documentation — ensuring that ventilation systems contribute to infection control and operational continuity across healthcare estates.
While BS EN 13053 and BS EN 1886 govern general ventilation performance across Europe, HTM 03 01 is unique in that it sets additional, stricter requirements specifically for hospitals and clinical environments. It is mandatory for all new and major refurbished NHS healthcare facilities in England and is widely adopted as best practice in devolved nations and the private healthcare sector.
Failing to comply with HTM 03 01 can result in legal exposure, procurement rejection, or rework, but more importantly, it can compromise the delivery of safe and effective care. Understanding its requirements is therefore critical for consultants, specifiers, contractors, estates teams, and equipment manufacturers alike
How does HTM 03 01 differ from standard AHU design practice?
HTM 03 01 goes far beyond typical HVAC design standards. It enforces more stringent criteria in nearly every area, from component selection to airflow control, hygiene access, and lifecycle documentation. The key differences include:
- Filtration Requirements
HTM 03 01 mandates higher-grade filters than standard EN 13053 configurations. Most healthcare AHUs must include a minimum of F7 (ISO ePM1 70 percent) pre-filters and F9 (ISO ePM1 80–90 percent) secondary filters. Where protection against pathogens is critical, HEPA filters (H13 or H14) may be required downstream, particularly in operating theatres, isolation rooms, and sterile services. All filters must comply with ISO 16890 or EN 1822 classifications, and filter housings must support positive sealing, zero bypass, and inspection access. Pressure drop monitoring is required to support ongoing performance tracking. HEPA filters must be individually certified and leak-tested during commissioning. - Redundancy and Resilience
N+1 or duty/standby configurations are strongly recommended for all critical services. Fan redundancy is typically achieved via dual fan arrays or EC plug fans with automatic changeover. HTM 03 01 also expects twin filters and duplicate control components in some scenarios to guarantee uninterrupted operation. All systems must maintain compliant airflow under fault conditions and include fail-safe strategies such as energy recovery bypass and zone isolation. Control panels must report faults to the BMS and support local override where necessary. - Hygiene and Cleanability
Internal surfaces must be smooth, non-porous, and cleanable, with sealed corners and minimal internal obstructions. Drainage from cooling coils, humidifiers, and base trays must be efficient and accessible. Drain trays must be constructed from non-corroding materials, fall continuously to a visible drainage outlet, and have a minimum slope of 1 in 20. They must be tested during commissioning to verify flow, and any evidence of standing water or microbial build-up must be rectified immediately. Poor drainage design is a known cause of HTM validation failure. Access panels must be large enough for inspection and physical cleaning, and located at all major component stages. - Casing Integrity and Leakage Class
HTM 03 01 requires AHUs to meet at least Leakage Class L2 (to BS EN 1886), with Class L1 often preferred in theatres and isolation zones. Panel deflection under pressure must not exceed limits set out in Class D2 or better. Thermal transmittance must meet Class T2, and thermal bridging must be limited to TB2 or better. These standards limit energy loss, prevent microbiological growth, and ensure the structural and hygienic integrity of the casing envelope. All characteristics must be independently verified through factory acceptance testing and site commissioning. - Acoustic Performance
Noise targets are tighter in HTM 03 01-compliant environments due to patient sensitivity and the need for restful recovery. Acceptable noise levels are specified by room type and must be met through careful system design. Attenuators must be selected to minimise regeneration and facilitate cleanability. Acoustic linings must be smooth, impervious to moisture, and non-fibrous, particularly in systems serving high-risk areas. Casing breakout noise must also be considered. Sound pressure levels must be measured during commissioning and documented in the validation report. - Maintenance Access and Lifespan Planning
AHUs must be designed with long-term serviceability in mind. This includes sufficient clearance—typically at least 1 metre on all service sides—for filter changes, coil cleaning, and fan replacement. Access doors must be robust, side-hinged, and openable without specialist tools. Internal lighting and non-slip flooring are recommended where personnel access is required. HTM 03 01 also mandates lifecycle information for all critical components including motors, dampers, sensors, and bearings, along with safe maintenance instructions aligned to COSHH and infection control protocols. - Documentation and Verification
All HTM 03 01-compliant systems must be supplied with comprehensive O&M manuals, performance certificates, commissioning data, and inspection schedules. These are mandatory and must include filter test results, airflow measurements, pressure cascade verification, acoustic assessments, and validation reports signed off by an independent Authorising Engineer (Ventilation). All control strategies must be verified and alarm systems tested. Clinical spaces must not be brought into service until full validation has been passed and documented.
What types of Healthcare Environments Require HTM 03-01 Complaint ventilation?
HTM 03-01 applies to all clinical spaces where ventilation directly influences patient safety, infection control, or staff protection. It defines environmental performance parameters for ventilation systems in acute care settings, and it is the primary compliance benchmark across all NHS England capital projects. It is mandatory for new builds and major refurbishments and is widely applied in the private healthcare sector and devolved nations as best practice.
The memorandum classifies healthcare environments by their clinical risk category and assigns ventilation performance requirements accordingly. These include air change rates, pressure regimes, filtration standards, and directional airflow protocols. HTM 03-01 Part A (Section 3.2 and Table 2) outlines these zones explicitly, with further operational guidance provided in Part B. The 2021 revision of HTM 03-01 tightened performance tolerances and reinforced the need for system-level design thinking, rather than purely component-based compliance.
- Operating theatres and anaesthetic areas
Ultraclean operating departments, including theatres, anaesthesia rooms, preparation and scrub zones, are subject to the most stringent HTM ventilation requirements. These include:
• 25 to 35 air changes per hour (ACH) in ultraclean zones
• HEPA filtration to EN 1822: H13 or H14 at supply terminals
• Unidirectional airflow fields with recovery velocities of 0.2 to 0.5 m/s
• Positive pressure cascades of ≥10 Pa to adjacent rooms
• Airflow verification per BS EN ISO 14644-3
Systems in these spaces must be validated at handover and revalidated annually, as per HTM 03-01 Part B Clause 6.5. The use of laminar flow or canopy systems must be assessed based on clinical function and operational risk.
- Isolation rooms and negative pressure suites
Designed to prevent pathogen escape, isolation rooms are essential for airborne infection control (e.g. TB, COVID-19, measles). Key features include:
• Negative pressure of -5 Pa relative to adjacent spaces
• Lobby or anteroom separation with differential pressurisation
• Extract-side terminal HEPA filters
• 10 to 12 ACH with controlled dilution patterns
• Pressure monitoring with alarm interlocks
Isolation rooms must be tested for pressure regime integrity, airflow direction, and air leakage pathways, as defined in HTM 03-01 Part A Clause 4.7. They are classified as either protective or source containment spaces, each with distinct design criteria.
- Critical care units (ICU, HDU, NICU)
Critical care zones must balance infection prevention with precise environmental control for thermally and immunologically vulnerable patients:
• 10 to 15 ACH depending on zone function and layout
• Temperature and humidity control within BS EN 13779 categories
• Central HEPA or high-grade F7/F9 filtration with terminal supply diffusers
• Zonal airflow balancing and noise limits below 45 dB(A) (ref. CIBSE Guide B2)
Systems must maintain tight control of recirculation, eliminate cross-connection with general ward supply, and ensure validation of pressure relationships.
- Pharmacy and aseptic suites
Pharmaceutical cleanrooms must comply with both HTM 03-01 and MHRA GMP (Orange Guide), particularly for aseptic compounding. Requirements include:
• Grade A to D room classification per EU GMP Annex 1
• ISO 14644-1 particle concentration limits
• Terminal HEPA filtration and laminar flow hoods (where required)
• Pressure cascades from clean to less clean areas
• Vibration control in accordance with ISO 14694 (fan assemblies)
HTM 03-01 Annex D provides a design crosswalk with BS EN ISO 14644. Validation must confirm air quality, airflow direction, and change rates under operating conditions.
- Endoscopy and decontamination areas
Endoscopy reprocessing generates aerosols and odours requiring controlled ventilation:
• 10 ACH minimum in both clean and dirty zones
• Airflow from clean to dirty with extract systems integrated into washers and disinfectors
• VOC and particulate filtration where chemical disinfectants are used
• Drainage systems compliant with HTM 01-06 and COSHH assessment criteria
Dedicated AHUs are strongly recommended to isolate functional risks from general ventilation systems. Containment of aerosolised contaminants is a key operational priority.
- Imaging, diagnostics and procedure rooms
X-ray, MRI, CT, and minor procedure rooms must meet general ventilation requirements and account for equipment heat loads, acoustic control, and airflow consistency:
• 6 to 10 ACH depending on room function and occupancy
• Controlled temperature and RH (typically 22–27°C and 40–60% RH)
• Low-velocity displacement supply preferred in noise-sensitive zones
• Electrical systems compliant with BS 7671 for imaging plant integration
Rooms using anaesthetic or radioactive gases must include leak detection, extract ventilation, and compliance with HTM 02-01 and relevant Health and Safety Executive guidelines.
Which ventilation system types does HTM 03 01 apply to?
HTM 03 01 applies to all mechanical ventilation systems serving healthcare premises, including both critical care and general treatment areas. The guidance defines minimum ventilation performance across a range of room types, from operating theatres to consulting rooms, wards, laboratories, and pharmacy suites.
The main system classifications under HTM 03 01 are:
- Conventional Ventilation (CV)
Used in most hospital areas, including general wards, offices, waiting rooms, and outpatient departments. These systems provide mixed supply and extract ventilation, often using a centralised AHU with ducted distribution. Design targets include air changes per hour (ACH), minimum filtration grade, and supply air temperature control. - Ultra Clean Ventilation (UCV)
Mandatory in certain operating theatres and cleanrooms. UCV systems feature high-efficiency HEPA filters (H13 or H14), unidirectional airflow, and dedicated supply/extract systems to maintain a sterile field. HTM 03 01 provides specific design requirements for canopy dimensions, airflow velocities (typically 0.2–0.3 m/s), and particle control. - Isolation Room Ventilation
Negative pressure isolation rooms must maintain directional airflow from clean to dirty zones. These systems require pressure differentials of –5 Pa to –10 Pa, HEPA-filtered exhaust air, and alarms for fan or pressure failure. Positive pressure isolation rooms, conversely, are used to protect immunocompromised patients and require tight air control with monitored leakage paths. - Specialist Spaces
These include pharmacies, laboratories, endoscopy suites, dental clinics, and imaging rooms. Each has its own ventilation strategy based on risk level. HTM 03 01 references additional Department of Health guidance (e.g. HBN 04-01 for isolation rooms) to ensure proper classification and control.
In all cases, the ventilation design must be justified via risk assessment and tailored to clinical function. HTM 03 01 does not prescribe a one-size-fits-all approach, instead, it demands systems that are fit for purpose, compliant, and maintainable.
HTM 03-01 is not enshrined in primary legislation, but it operates as the authoritative technical standard for ventilation in NHS England healthcare premises. It is referenced explicitly by the Care Quality Commission (CQC) and NHS audit frameworks and is treated as mandatory for all design, installation, and operational decisions relating to clinical ventilation.
The Health and Social Care Act 2008 (Regulated Activities) and the Health and Safety at Work etc. Act 1974 place a legal duty of care on providers to ensure patient safety and a hygienic care environment. HTM 03-01 provides the detailed ventilation framework by which these obligations are interpreted. In legal terms, failure to comply with HTM 03-01 may not constitute an offence, but it is admissible as evidence of non-compliance, negligence, or breach of statutory duty in the event of regulatory action or litigation.
For non-NHS providers—such as private hospitals, military medical centres, or overseas facilities, HTM 03-01 may function as best practice rather than binding regulation. Nonetheless, most UK-based consultants and contractors apply HTM 03-01 as the default standard for any environment involving surgical, sterile, or isolation-based clinical risk.
HTM 03-01 is increasingly recognised as a global benchmark for healthcare ventilation, particularly in regions seeking to adopt NHS-aligned design principles. While it was developed specifically for the UK public healthcare estate, its technical structure, infection control rationale, and prescriptive clarity make it a preferred standard in international hospital design.
Major new-build healthcare schemes across the Middle East, Southeast Asia, and Sub-Saharan Africa frequently specify HTM 03-01 as the primary ventilation code, particularly when UK-based architects, engineers, or funders are involved. It is especially valued in critical care zones, such as:
- Operating theatres (conventional and UCV)
- Isolation rooms (positive or negative pressure)
- Sterile service departments
- ICU and recovery suites
However, HTM 03-01 may intersect with or contradict other national frameworks—such as ASHRAE 170 (USA), DIN 1946-4 (Germany), or REHVA guidance documents. In such cases, a harmonisation strategy must be agreed at project inception to determine which standard takes precedence in areas of overlap or conflict
What is SHTM 03-01 and how does it differ from HTM 03-01?
SHTM 03-01 is the Scottish Health Technical Memorandum governing the design, installation, and management of specialised ventilation in NHS Scotland healthcare premises. It serves as the devolved equivalent of HTM 03-01, retaining the same fundamental structure and technical purpose while adapting certain procedures, terminologies, and responsibilities to the specific governance framework of NHS Scotland.
Structurally, both standards follow a three-part format—Design & Installation (Part A), Operational Management (Part B), and Validation & Verification (Part C). Technically, both reference the same European standards, including BS EN 13053 (performance of air handling units), BS EN 1886 (mechanical strength and leakage), ISO 14644 (cleanroom air cleanliness), and COSHH 2002.
However, SHTM 03-01 places greater emphasis on auditability, documentation traceability, and operational resilience. Validation cycles in Scottish sites often reflect more rigorous internal reporting, and Authorising Engineer roles may carry broader consultative scope. The practical design differences are minimal, but stakeholder expectations during commissioning and revalidation may vary by Health Board.
From a manufacturer or consultant standpoint, full compliance with SHTM 03-01 requires no changes to physical equipment but does demand awareness of local sign-off processes. Mansfield Pollard designs are fully compatible with both standards, and our documentation suites can be tailored to meet either NHS England or NHS Scotland audit frameworks.
What are the air change rate (ACH) and pressure requirements?
HTM 03 01 mandates strict air change rate (ACH) and pressure regime requirements to ensure airborne infection control, environmental stability, and clinical safety across healthcare environments. These parameters vary by room type and clinical function and are not optional—they are enforceable operational standards that must be both achieved and validated.
Air Change Rates
ACH refers to the number of times the total air volume in a room is replaced per hour. HTM 03 01 Part A, Table 2.1, defines minimum rates for a range of clinical settings. Key examples include:
- Operating Theatres (Ultra-Clean Ventilation / UCV): ≥25 ACH within the canopy, delivered via unidirectional (laminar) airflow with terminal HEPA filtration (EN 1822 H13 or H14)
- Operating Theatres (Conventional): ≥20 ACH, with a positive pressure cascade to adjacent areas
- Treatment Rooms: ≥10 ACH
- Consulting Rooms: ≥6 ACH
- Dirty Utility Rooms: ≥10 ACH
- Isolation Rooms (Negative Pressure): ≥10 ACH overall, with a minimum of 2 ACH via extract to sustain directional airflow
Additional environments such as sterile preparation areas, endoscopy suites, and aseptic cleanrooms may require enhanced air change rates depending on contamination risk, activity type, or alignment with other guidance (e.g. HTM 01-01 for decontamination).
Air change performance must be tested under both design and operational conditions and revalidated at regular intervals per HTM Part B. Merely achieving values at design stage is not sufficient for compliance.
Pressure Regimes
Pressure differentials between adjacent spaces are a core mechanism for infection prevention and environmental zoning. HTM 03 01 defines specific minimum values that must be measured and sustained during system operation:
- Positive Pressure Rooms: Clean zones such as operating theatres, cleanrooms, and sterile prep areas must maintain a minimum differential of +10 Pa relative to adjacent spaces to ensure outward airflow.
- Negative Pressure Rooms: Containment zones such as isolation suites, dirty utility rooms, and certain decontamination spaces must sustain –5 Pa to –10 Pa relative to surrounding areas, using extract-side HEPA filters to prevent escape of airborne pathogens.
- Neutral Pressure Rooms: Low-risk environments such as waiting rooms or staff offices may operate at ambient pressure with no enforced pressure differential.
Pressure regimes must be supported by robust system design including airtight door sets, interlocked lobbies where necessary, and appropriately sized ductwork. Pressure monitoring must be continuous and locally visible—typically via calibrated sensors, manometers, or digital BMS readouts—and configured to trigger alarms when excursions occur.
HTM also mandates that systems include pressure relief dampers or transfer grilles, where appropriate, to ensure pressure stability under part-load or fault conditions. Failure to maintain pressure cascades is a critical compliance breach and a leading cause of revalidation failure under HTM Part B.

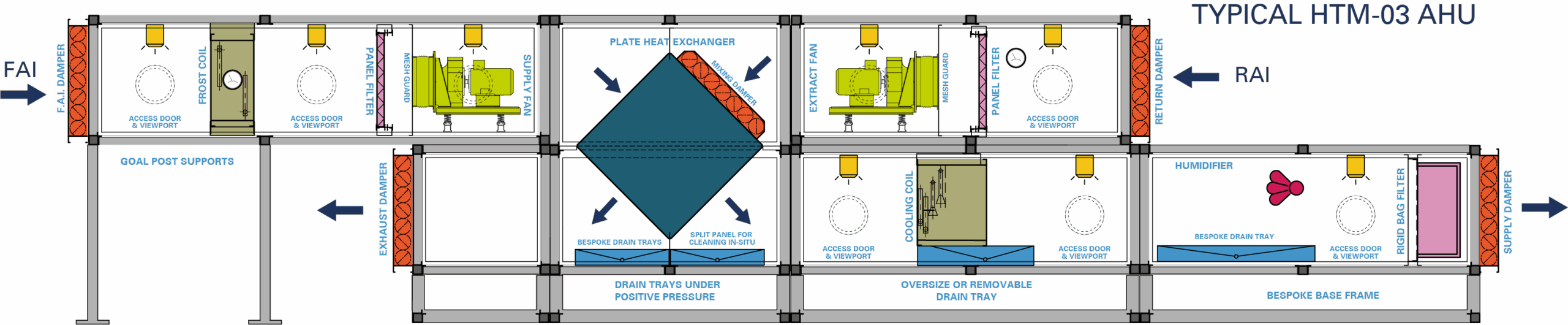

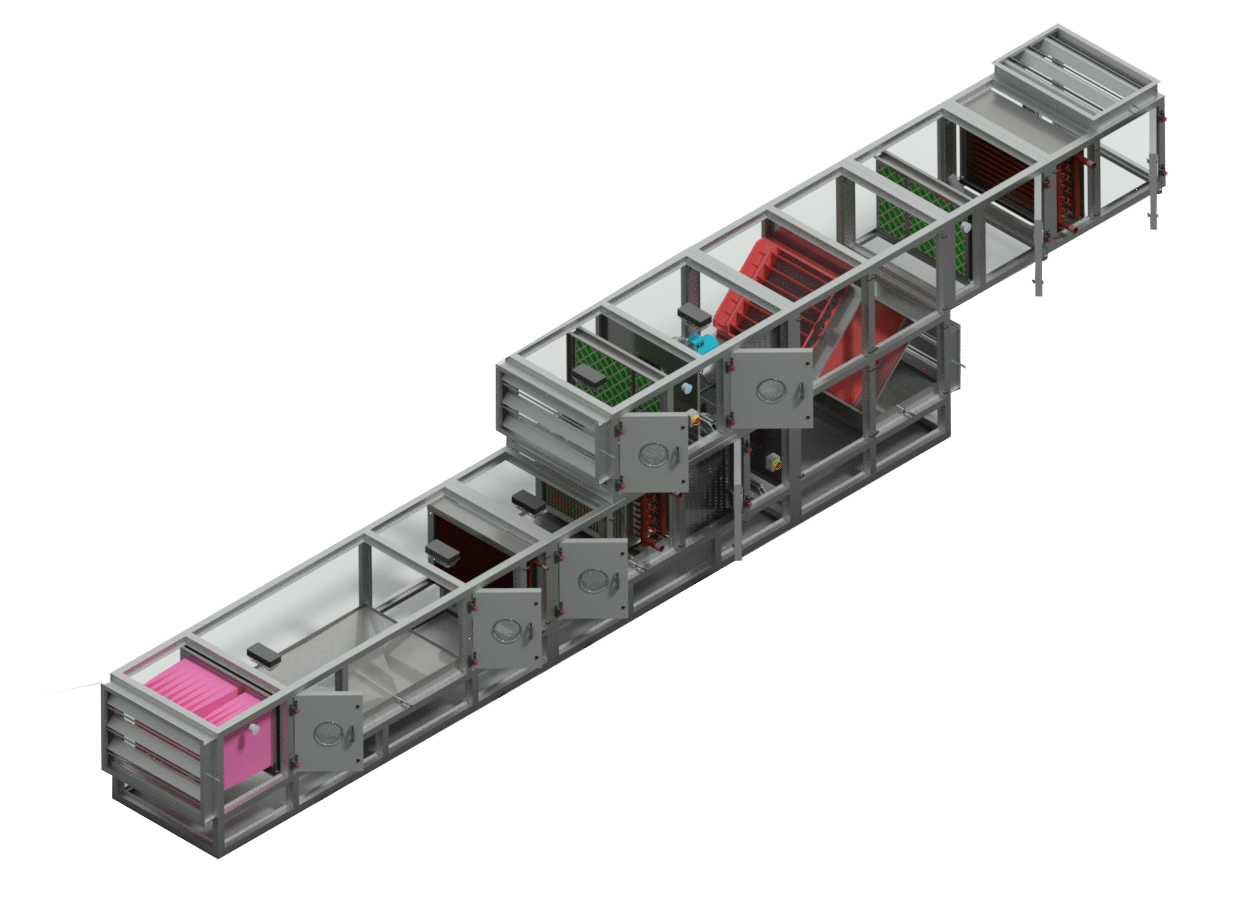

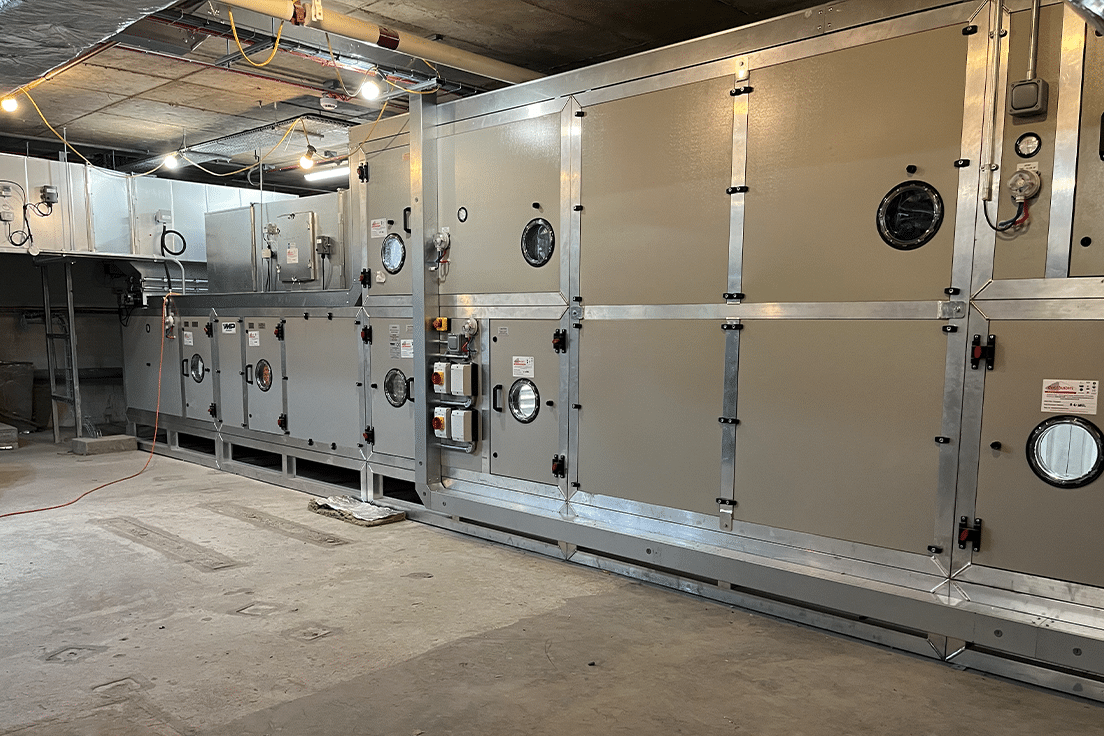

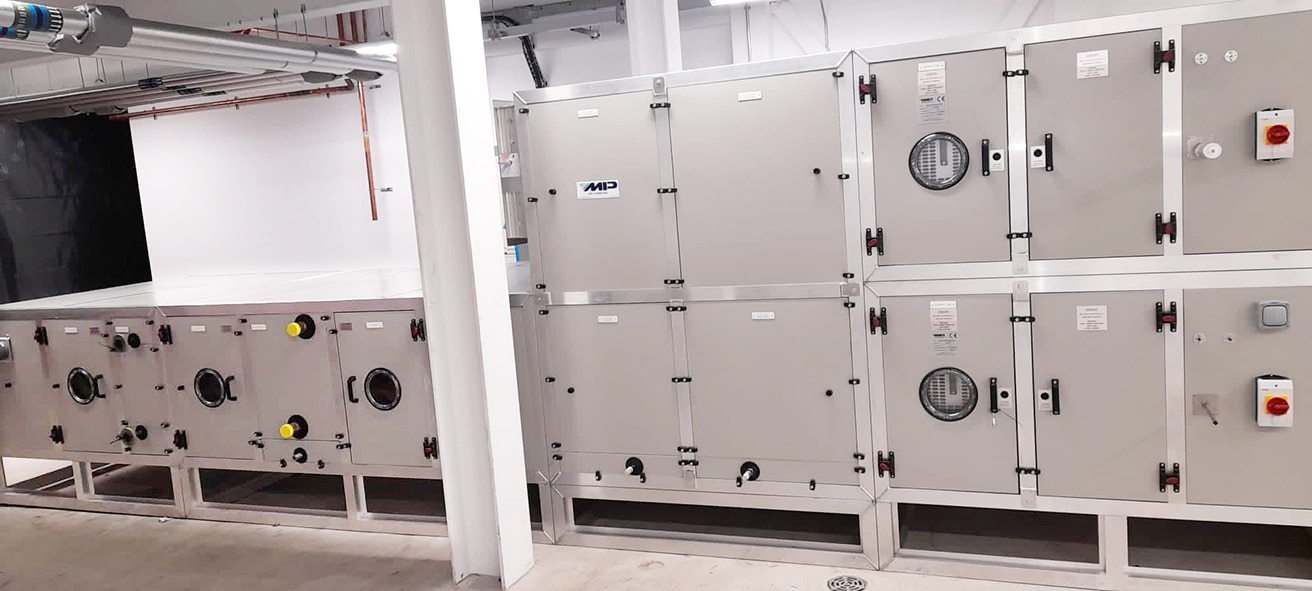

How must air handling units (AHUs) be designed to comply with HTM 03 01?
Air handling units (AHUs) used in healthcare environments must be specifically engineered to meet the combined demands of infection control, system hygiene, operational resilience, and maintainability. HTM 03 01 Parts A and B define these requirements in detail, setting a mandatory framework that extends beyond standard commercial ventilation expectations. Non-compliant AHUs risk failing commissioning, breaching statutory obligations, or compromising patient safety and clinical functionality.
- Sectional Construction and Maintenance Access
AHUs must be sectionalised for full, unobstructed access to all components. HTM-compliant layouts require:
- Minimum 1 metre clear working space on all serviceable sides
- Side-hinged access doors rated for positive or negative pressure
- Tamper-resistant catches or interlocks to prevent unsafe entry during fan operation
- Illuminated access compartments and cleanable, anti-slip flooring (for walk-in units)
Maintenance corridors (as recognised under HTM 03 01 para 4.13) may be required for weatherproof external units and must be IP65-rated, structurally integrated, and match AHU construction standards.
- Filtration Requirements
A two-stage filtration system is mandatory:
- Stage 1: G4 or ISO Coarse 70% pre-filter
- Stage 2: F7 or ISO ePM1 ≥65% final filter
For critical areas (e.g. operating theatres, isolation), HEPA filters (EN 1822: H13/H14) must be installed either in-terminal or within the AHU. All filters must:
- Be housed in gasket-sealed, leak-tight frames
- Include visual inspection access and differential pressure sensors
- Be accessible for safe change-out without dismantling structural panels
- Fan Configuration
Fans must be direct drive — belt-driven assemblies are prohibited due to contamination risk. Requirements include:
- EC plug or backward-curved centrifugal fans
- ISO 14694 compliance for balancing and vibration
- Anti-vibration mounts and acoustic treatment to reduce breakout
- Dual fans, N+1 arrays or duty/standby operation for all HTM-critical systems
- Auto-changeover logic, validated during commissioning
- Internal Cleanability
Internal hygiene is a core compliance pillar. AHUs must feature:
- Smooth, sealed, corrosion-resistant internal surfaces
- Closed-cell or encapsulated insulation only — no exposed fibrous materials
- Drain trays under all wet coils with 1:80 fall, trapped discharge and visible outlets
- No internal ledges or recesses where microbial growth could occur
- Casing, Thermal, and Acoustic Performance
Casing performance must meet BS EN 1886 minimum classes:
- Leakage Class: L1 (preferred) or L2
- Strength Class: D1 or D2
- Thermal Transmittance: T2 or better
- Thermal Bridging: TB2 or better
Casing breakout sound must be minimised using non-fibrous linings, silencers, and optimal fan selection. HTM 03 01 Annex B defines strict acoustic targets (e.g. ≤35 dB(A) in single-bed wards), which must be modelled and validated on-site.
- Controls and Monitoring
AHUs must be fully integrated into the hospital’s BMS and feature:
- Local isolators for fan motors
- Filter pressure sensors and alarms
- Supply/extract airflow and environmental condition monitoring
- Fail-safe control logic with override functions for commissioning and emergency shutdown
- Alarms for airflow failure, over-temperature, fan faults, and HEPA integrity loss (if applicable)
- Location and Installation
AHUs must be installed with consideration to:
- Safe, accessible maintenance clearances
- Non-placement over clinical spaces without full risk assessment and mitigation
- Weatherproofing, frost protection, and ingress prevention for outdoor units
Where roof-mounted, protective enclosures or maintenance corridors may be mandated under HTM 03 01.
Commissioning and Validation
All HTM-compliant AHUs must undergo:
- FAT (Factory Acceptance Testing) to confirm construction and performance
- SAT (Site Acceptance Testing) to validate integration and function
- Independent validation to confirm airflow, pressure regimes, filtration, and hygiene
Documentation — including test reports, filter certificates, and Authorising Engineer sign-off — forms part of the final compliance file.

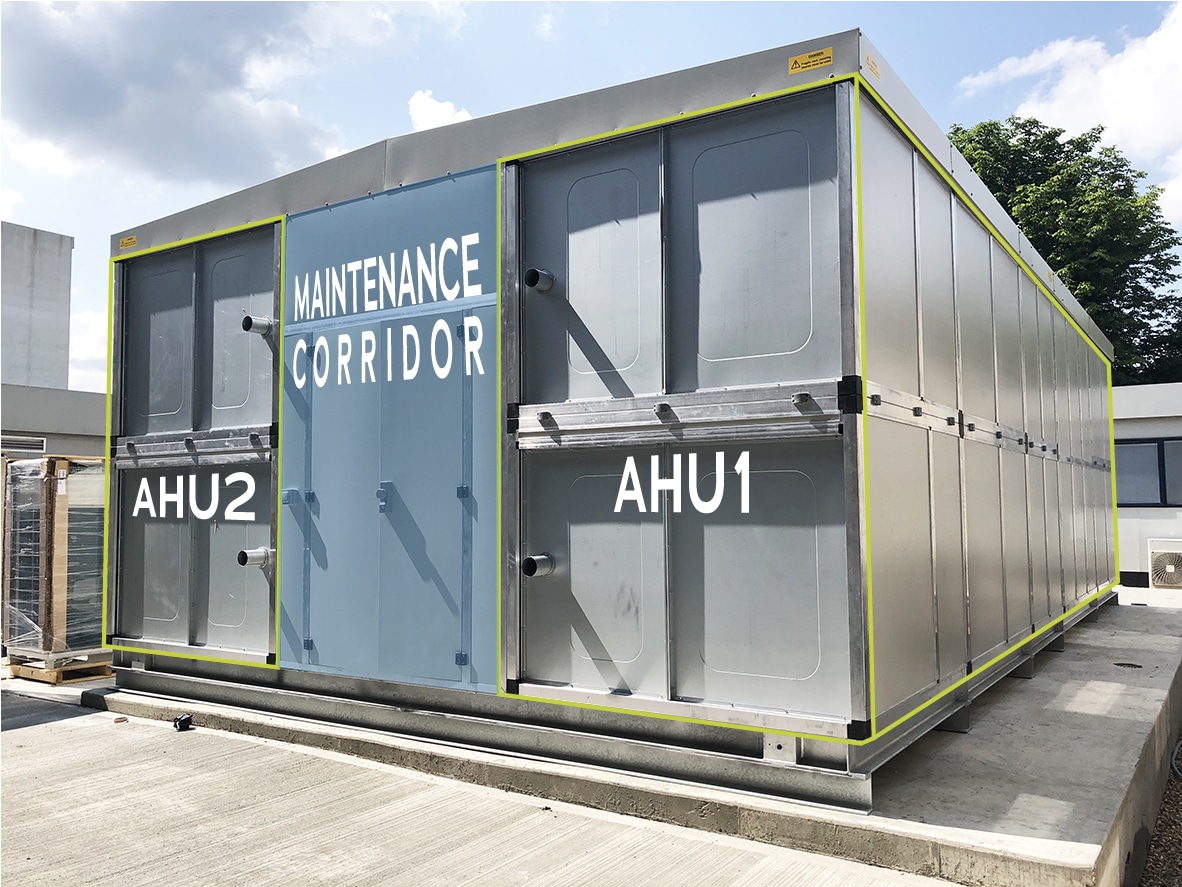

What are the HTM 03-01 Requirements for AHU Maintenance Corridors?
Maintenance corridors are a critical but often underestimated component in achieving HTM 03-01 compliance, particularly for externally mounted air handling units (AHUs). These corridors provide essential access for inspection, servicing, and emergency intervention—tasks that must be executed safely, hygienically, and without exposure to adverse weather or contamination risks.
HTM 03-01 Part A explicitly recognises the functional equivalence of enclosed corridors and dedicated plantrooms. Where correctly designed and constructed, these structures offer a compliant and efficient alternative to full mechanical rooms.
Paragraph 4.13 of HTM 03-01 Part A states:
“External ventilation units should be fully weatherproof to IP65 and secured from unauthorised access. Protection against the elements should also be provided for personnel carrying out routine inspection and maintenance activities. As an example, when two units are outside, and they are installed with their access doors facing each other, if the gap between them is roofed over and the open ends capped, the AHUs themselves create what is in effect a plantroom.”
This clause supports the inclusion of prefabricated, enclosed maintenance corridors as an integral part of HTM-compliant AHU solutions. These corridors are not optional in exposed installations—they are a direct response to HTM’s requirement for safe and weather-protected access.
Mansfield Pollard Maintenance Corridor Specifications
Mansfield Pollard’s AHU maintenance corridors are engineered specifically to address this HTM requirement. Built from the same TB2 or TB3-rated structural framing and hygienic panelling systems as the AHUs themselves, MP corridors ensure performance parity across the full assembly.
Key specification features include:
- Weatherproofed Envelope: Fully welded or sealed construction with IP65 ingress protection, integrated gussets, and anti-corrosion coatings.
- Access and Egress: Lockable double-leaf doors with internal emergency release hardware to support HTM egress requirements and site-specific security policies.
- Service-Grade Flooring: Galvanised or stainless steel checker plate, with sump recesses for condensate control, and optional non-slip grating.
- Lighting and Power: IP65-rated LED lighting systems, protected cable runs, and containment trays for pipework, valves, and services.
- Mechanical Integration: Mounts directly onto galvanised base frames, aligning with AHU skids for seamless installation. Optional supports for duct or pipe penetration.
- Custom Options: Raised ceilings, anti-ligature fittings, cleanroom linings, and internal access panels to suit high-risk or HTM-critical plant.
Benefits Over Site-Built Enclosures
Unlike improvised lean-tos or on-site timber/steel frameworks, Mansfield Pollard corridors are prefabricated to the same QA-controlled standards as the AHUs they support. This ensures verifiable casing performance, installation efficiency, and a documented compliance pathway aligned with HTM validation processes.
In high-risk environments—such as theatres, isolation rooms, or critical care plant—MP corridors support revalidation efforts by maintaining environmental continuity, access clarity, and containment integrity.
Conclusion
For any HTM 03-01 project involving externally sited AHUs, the inclusion of a compliant, prefabricated maintenance corridor is not just a best-practice enhancement—it is a compliance enabler. It addresses key requirements for environmental protection, safe access, and operational continuity, and it provides a clear solution to the otherwise ambiguous instruction to protect service personnel “against the elements”.
Can standard commercial AHUs be upgraded to meet HTM 03-01?
Upgrading a standard commercial air handling unit (AHU) to meet HTM 03-01 is theoretically possible—but it requires a detailed, case-by-case assessment and is rarely a straightforward retrofit. HTM 03-01 sets stringent design, hygiene, maintenance, and validation standards that exceed typical commercial specifications. Any upgrade path must therefore be strategically planned, comprehensively documented, and subject to formal verification.
Where upgrades may be feasible
Certain commercial AHUs can be made HTM-compliant through targeted interventions, particularly in non-critical healthcare settings. Common upgrade paths include:
- Filtration enhancements: Installing two-stage filtration (e.g. F7 + H13 HEPA) in pressure-tight housings with zero bypass.
- Drainage improvements: Retrofitting positively sloped, stainless steel drain pans and COSHH-compliant discharge arrangements.
- Access modification: Enlarging service doors, reorienting components, and adding lighting or safe access routes to meet maintenance corridor requirements.
- Fan and motor upgrades: Replacing belt-driven systems with EC plug fans to eliminate hygiene risks and enable redundancy.
- Control system integration: Upgrading legacy controls to interface with BMS platforms and support alarm, override, and fail-safe functionality.
Where upgrades typically fall short
However, there are multiple areas where retrofitting a standard AHU will often prove non-compliant or cost-ineffective:
- Casing classification: Most commercial AHUs do not meet the HTM-specified BS EN 1886 classes (e.g. L1 leakage, T2 thermal, TB2 bridging) and cannot be easily retrofitted to do so.
- Internal cleanability: Surfaces, fixings, and insulation in standard units are rarely designed for clinical cleaning protocols and may breach infection control policies.
- Maintenance and validation access: Retrofitted units may not allow safe coil or filter removal, compromising operational sign-off.
- Governance compliance: Upgrades must be validated by the Trust’s Authorising Engineer (Ventilation) and may still be rejected on policy or legacy grounds.
The MP approach to HTM refurbishment
At Mansfield Pollard, we offer bespoke HTM refurbishment services for AHUs that have sufficient structural and spatial suitability. This includes:
- Full site survey and engineering appraisal
- Component-by-component HTM gap analysis
- Strip-out and replacement of non-compliant elements
- Re-certification testing aligned to BS EN 13053, 1886 and HTM 03-01
- Updated documentation and commissioning support for Trust acceptance
Where refurbishment is not viable, we provide HTM-compliant AHUs designed from first principles, including modular plantroom and rooftop containerised solutions to simplify replacement.
Summary
HTM 03-01 compliance can sometimes be achieved through upgrading, but only where the base unit provides an acceptable platform for transformation. In most cases, compliance is best guaranteed through purpose-built HTM designs, particularly in high-risk environments. A formal audit, involving both the manufacturer and the Trust’s AE(V), is essential before deciding between upgrade and replacement.
What testing, commissioning, and documentation is required under HTM 03 01?
HTM 03 01 places critical importance on the commissioning, validation, and documentation of ventilation systems serving healthcare premises. This is not simply a functional check, but a formal process that ensures systems are safe, hygienic, and compliant with clinical performance requirements. No ventilation system may serve a clinical space without documented evidence of its validated performance, verified by an independent specialist.
Commissioning and testing must be conducted by competent professionals, and all results must be reviewed and signed off by the Authorised Person (Ventilation). For high-risk areas, independent validation by an Authorising Engineer (Ventilation) is required prior to clinical occupation.
Key Testing and Commissioning Requirements
- Airflow Performance Verification
- All supply and extract volumes must be measured and balanced to align with design intent.
- Minimum air change rates must be confirmed in accordance with HTM 03 01 Part A, Table 2—for example:
- 25 to 35 ACH within UCV canopies
- ≥20 ACH in conventional theatres
- ≥10 ACH in treatment and utility rooms
- Static pressure readings must confirm duct and terminal performance under operational load.
- Filter Integrity and Pressure Drop Testing
- Initial pressure drops across pre-filters and final filters must be recorded and used as baseline data for maintenance planning.
- Where HEPA filters are installed, integrity must be verified using a validated method such as DOP or PAO testing.
- Filter frames and housings must be leak tested to prevent bypass and ensure effective air treatment.
- Casing and Mechanical Performance (BS EN 1886 Compliance)
- AHU assemblies must be tested to confirm:
- Leakage class (L1 recommended)
- Mechanical strength (typically D1 or D2)
- Thermal transmittance (T1 to T5 as applicable)
- Bridging factor (TB1 to TB5 for insulation integrity)
- AHU assemblies must be tested to confirm:
- Electrical, Controls, and BMS Integration
- Emergency stops, local isolators, and thermal protection must be verified.
- Control strategies must be tested under real conditions, including:
- Fan speed control
- Damper modulation
- Heater coil and sensor response
- BMS integration must be verified with full status, fault, and override feedback.
- Acoustic and Vibration Assessment
- Where required by specification or site condition, in-situ noise levels must be verified to remain within HTM 03 01 limits (e.g. NR 40 in operating theatres).
- Fan assemblies must meet vibration thresholds defined in ISO 14694, and readings must be recorded to support commissioning reports.
- Microbiological and Visual Cleanliness
- AHUs, ductwork, and terminal devices must be visually clean and free from construction debris.
- In critical zones, microbiological swabbing or ATP testing may be required to prove readiness.
- Drain trays, humidifiers, and filters must be free of standing water and microbial growth.
Mandatory Documentation and Reporting
To comply with HTM 03 01, a full suite of commissioning and validation documents must be compiled and maintained. These include:
- FAT and SAT reports (if applicable)
- Commissioning logs with airflow and pressure readings for every terminal
- Filter certificates, particularly for HEPA filters with individual leak test results
- Electrical installation and safety certificates
- O&M manuals containing:
- Schematic and ductwork drawings
- Wiring and control schematics
- Filter change procedures
- Preventive maintenance schedules
- Spare parts list and component lifespans
Sign-Off and Governance Requirements
All testing must be witnessed and documented by the commissioning engineer. Final validation must be performed by an independent validator (typically the Authorising Engineer) and submitted to the Ventilation Safety Group. Clinical areas may not be occupied until validation is complete and all documentation is formally accepted.
HTM 03 01 views commissioning as a regulated milestone, not an optional handover activity. Failure to produce compliant documentation or validation evidence may result in delayed occupation, rework, or regulatory breach.
What are the biggest compliance risks and how can they be avoided?
Despite its clarity and detailed requirements, HTM 03 01 is frequently misunderstood, misapplied, or incompletely implemented. This creates significant risks not only for regulatory compliance, but also for clinical safety and long-term system performance. Most non-compliance issues arise from design oversights, installation shortcuts, or documentation failures—many of which are avoidable with better coordination and awareness.
The following are the most common HTM 03 01 compliance risks, along with strategic solutions to mitigate them.
- Using “Standard” AHUs in HTM Applications
One of the most critical mistakes is assuming that a commercial-grade AHU can be modified post-specification to meet HTM standards. This often results in systems that superficially comply (e.g. correct airflow, added filtration) but fail when assessed for casing integrity, hygiene access, or lifecycle resilience.
Risk Factors:
- Inadequate casing strength and leakage control
- Poor internal cleanability and inaccessible drains
- Inability to accommodate HEPA filters or pressure control
Solution: Specify HTM-compliant AHUs from the outset. Select manufacturers with proven NHS experience and product lines that meet or exceed BS EN 1886 classifications (typically D2, L1, T2, TB2). Avoid retrofitting standard units for clinical use.
- Overlooking Redundancy Requirements
HTM 03 01 requires N+1 fan redundancy or duty/standby arrangements in all critical healthcare environments. Systems without fan redundancy present a single point of failure—risking service loss, infection control breaches, and clinical disruption.
Risk Factors:
- Single-fan units in theatres or isolation zones
- No automatic changeover system
- Manual restart required after fault
Solution: Specify dual EC fan walls or twin centrifugal fans with auto-changeover. Confirm redundancy is reflected in both mechanical design and control logic. Validate functionality during commissioning.
- Improper HEPA Filter Installation
HEPA filters play a critical role in ultra-clean environments but are often installed without due consideration for housing design, seal integrity, or testing access. This undermines filtration performance and invalidates the system’s HTM compliance.
Risk Factors:
- Non-certified filter housings
- No upstream/downstream DOP test ports
- Inadequate gasket compression or damaged seals
Solution: Use factory-tested terminal housings designed for EN 1822 filters. Commissioning must include DOP or PAO testing using challenge aerosol methods. Verify test ports and seal integrity before handover.
- Failure to Document Commissioning and Validation
Projects regularly fail HTM validation not because of technical flaws, but because essential documentation is incomplete, inconsistent, or missing. HTM 03 01 places equal weight on evidence as it does on performance.
Risk Factors:
- Missing airflow data or pressure readings
- No commissioning sign-off by Authorised Person (Ventilation)
- O&M manuals lacking filter specs or inspection protocols
Solution: Develop a structured validation and handover plan during project design. Maintain commissioning logs in real time. Engage the Authorised Person early to ensure all documentation expectations are met.
- Inadequate Cleaning Prior to Handover
HTM 03 01 mandates that all ventilation systems be hygienically clean at the point of commissioning. Systems contaminated with construction dust, standing water, or microbial residue often fail inspection and require expensive cleaning and revalidation.
Risk Factors:
- Filters installed before internal duct and AHU cleaning
- No visual or swab inspection prior to handover
- Contaminated drain trays or inaccessible internal surfaces
Solution: Conduct full duct and AHU cleaning before filter installation. Use contractors trained in HTM-aligned protocols. Include microbiological cleanliness in your commissioning checklist, especially for theatres, isolation rooms, and sterile zones.
- Weak Governance and Role Confusion
HTM 03 01 compliance depends on clear governance—specifically through defined roles such as the Authorising Engineer (Ventilation), the Authorised Person, and the Ventilation Safety Group. Many failures stem from a lack of role clarity or inadequate oversight.
Risk Factors:
- No formal appointment of Authorising Engineer
- Poor communication between estates, design, and clinical teams
- No VSG involvement in derogation or change control
Solution: Establish governance early in the project. Document responsibilities. Involve clinical stakeholders, infection control, and engineering teams in all design and commissioning decisions. Use the VSG to approve exceptions and oversee system lifecycle planning.
How does HTM 03 01 compare to BS EN and Ecodesign standards?
HTM 03 01 sits alongside—but does not replace—core British and European ventilation standards such as BS EN 13053, BS EN 1886, and Ecodesign Regulation (EU) 2016/2281. Understanding how these standards overlap, differ, and interact is essential for consultants, specifiers, and manufacturers delivering compliant solutions for healthcare environments.
- Structural and Mechanical Standards
BS EN 1886 defines the mechanical performance characteristics of air handling units, including casing strength, air leakage, filter bypass, and thermal bridging. HTM 03 01 references this standard extensively and sets specific minimum thresholds derived directly from it. Typical HTM 03 01 requirements include:
- Leakage Class: Minimum L2, with Class L1 preferred for critical areas such as operating theatres and isolation suites
- Casing Strength: Class D1 or D2 to ensure structural stability under pressure
- Thermal Performance: Thermal transmittance (T1–T5) and thermal bridging (TB1–TB5) ratings aligned to infection control goals
HTM 03 01 does not supersede BS EN 1886. Instead, it builds upon it, interpreting selected performance classes as mandatory for healthcare applications. Any AHU that fails to meet these mechanical criteria cannot be considered HTM compliant.
- Ventilation Performance Standards
BS EN 13053 governs operational parameters for ventilation systems, including airflow capacity, pressure losses, fan power, and component efficiencies. It serves as the technical foundation for evaluating system performance and is fully recognised within HTM 03 01. However, HTM introduces additional, healthcare-specific requirements that exceed standard EN expectations:
- Higher filtration grades (e.g. ISO ePM1 80% or H13) depending on risk zone
- Recirculation restrictions in clinical and sterile spaces
- Enhanced redundancy, access, and validation criteria
For instance, while BS EN 13053 may permit recirculation under certain energy-efficiency conditions, HTM 03 01 prohibits it in areas where contamination risk is unacceptable.
- Ecodesign Regulation (EU) 2016/2281
Ecodesign sets minimum energy performance standards (MEPs) for ventilation units, including specific fan efficiencies and mandatory heat recovery thresholds. HTM 03 01 recognises these sustainability drivers but subordinates them to patient safety. Where energy-saving features introduce infection control risks—such as cross-contamination via rotary heat exchangers—HTM permits deviation from Ecodesign requirements.
Example: An extract AHU serving an operating department may be exempt from heat recovery under HTM 03 01 if the risk of microbial transfer outweighs the energy benefit, even though Ecodesign would ordinarily require it.
HTM 03 01 also promotes sustainable design in its own right, encouraging efficient fans, variable volume controls, and commissioning protocols to minimise waste over system life.
- Regulatory Hierarchy
In all NHS and regulated healthcare projects, HTM 03 01 represents the statutory ventilation benchmark. While BS EN and Ecodesign standards underpin the technical conformity of components and systems, they remain subordinate to HTM in matters of compliance.
- HTM 03 01: Clinical and operational compliance benchmark for UK healthcare
- BS EN Standards: Provide the engineering and performance basis for system design
- Ecodesign Regulation: Guides energy efficiency, unless overridden by HTM risk criteria
In practice, a fully compliant healthcare ventilation system will satisfy the relevant BS EN and Ecodesign requirements in addition to the specific demands of HTM 03 01. Where conflicts arise, HTM takes precedence.
What documentation is required for HTM-compliant handover?
An HTM 03 01-compliant ventilation system must be supported by a robust and structured documentation package. This ensures ongoing compliance, enables safe operation, and provides a verifiable record for commissioning, validation, and lifecycle maintenance. In healthcare contexts, documentation is not merely a contractual formality—it is a core pillar of regulatory assurance.
The handover documentation must typically include:
- Operation and Maintenance (O&M) Manuals
These must be comprehensive and tailored to the as-installed system. At minimum, they should include:
- Full component list with manufacturer, model numbers, and supplier contact details
- Fan curves, filter data (including filter class, pressure drop, and loading guidance), coil performance and materials
- Electrical schematics and control logic diagrams, including terminal wiring and BMS interface details
- Inspection, cleaning, and filter replacement instructions specific to site conditions
- FAT (Factory Acceptance Test) and SAT (Site Acceptance Test) summaries, including observed versus design values
- Full lifecycle maintenance instructions and recommended spares schedule
Generic O&M documentation is not sufficient. Manuals must reflect the final installed condition, validated test results, and site-specific configurations.
- Commissioning and Validation Records
HTM 03 01 mandates that all critical ventilation systems undergo detailed performance validation post-installation. This includes:
- Verified airflow and pressure measurements at all terminals, compared against design criteria
- Initial pressure drops across each filter stage and filter grade confirmation (ISO ePM1 or H13/H14 as applicable)
- Leakage and deflection test results for AHU casings (BS EN 1886 compliance)
- Control system logic validation, including damper sequencing, alarm tests, and fail-safe response
- Sound power or noise level readings in acoustically sensitive spaces
- Microbiological cleanliness verification for theatres, isolation rooms, and aseptic zones (if specified)
All validation results must be signed off by the appointed Authorised Person (Ventilation).
- As-Built Drawings and General Arrangement (GA) Schematics
These must accurately reflect the installed system and include:
- Final duct routing and riser details
- Access zones and service clearance diagrams
- Fire and smoke damper positions
- Locations of balancing dampers, pressure monitoring points, and isolation valves
- AHU maintenance corridor integration (if applicable)
Digital files (DWG and PDF formats) are required and must be provided to the Trust’s estates or technical records teams.
- Manufacturer Certification
Each component used in the system must be accompanied by third-party or manufacturer certification to confirm compliance. This includes:
- AHU casing performance to BS EN 1886 (leakage class, strength class, thermal transmittance, TB classification)
- Filter classification and ISO 16890 or EN 1822 certification
- Fan and motor compliance, including vibration testing to ISO 14694
- Electrical equipment conformity (BS 7671, CE/UKCA marking, IP rating)
- Software validation for BMS or standalone control systems (if applicable)
Certificates must be collated and traceable to the installed products.
- Maintenance Schedules and Logbooks
HTM 03 01 requires the inclusion of post-handover maintenance planning documents. These should define:
- Filter replacement intervals by grade and expected loading
- Inspection frequency for key components: coils, fans, dampers, sensors, and drainage
- Validation re-test timelines: annual for critical spaces, biennial for general areas
- Alarm and control test intervals
- Record-keeping formats for filter changes, fault logs, and service interventions
Templates for logbooks or digital CMMS integration should be provided where available.
Important Note:
Incomplete or non-compliant handover documentation may delay NHS approvals, invalidate warranties, or prevent clinical sign-off. NHS Trusts increasingly require digital document portals and structured metadata for record searchability. Authorised Persons and Ventilation Safety Groups place significant weight on documentation completeness, clarity, and traceability as a condition of acceptance.
What mistakes commonly lead to HTM non-compliance?
Despite best intentions, many AHU and ventilation installations fail to meet HTM 03 01 requirements due to avoidable missteps. These can occur at design, procurement, installation, or commissioning stages and often result in costly rework, project delays, or refusal of clinical sign-off by NHS Authorising Engineers.
Here are the most frequent causes of HTM non-compliance:
- Using Standard (Non-HTM) AHUs
Perhaps the most fundamental error is assuming that a commercial-grade AHU can be made HTM-compliant by simply adjusting specifications post-design. Standard units often lack:
- Filter configurations aligned with ISO 16890 or EN 1822
- Internal access suitable for hygiene inspection and physical cleaning
- Drainage systems designed to prevent water retention or microbial growth
- Component segregation for fan redundancy or filter change-out
- Encapsulated insulation and corrosion-resistant linings
Procurement teams must explicitly specify HTM compliance from the outset. Compliance with BS EN 13053 or BS EN 1886 alone is not sufficient without supporting evidence of HTM-specific features and documentation.
- Inadequate Access and Maintenance Provision
HTM 03 01 places significant emphasis on the maintainability and cleanability of ventilation systems. Units must be configured so that:
- All component stages (filters, coils, fans, dampers) are accessible for inspection and manual cleaning
- Access panels are positioned to permit safe reach and tool-free operation
- Doors open with sufficient clearance for component removal
- Drain trays are visible, sloped, and fitted with testable traps
Failure to integrate these factors during design layout, particularly for plantroom or rooftop installations, frequently leads to rework at late project stages.
- Acoustic Performance Underestimated
Noise control in hospital environments is a clinical requirement—not a discretionary design option. HTM 03 01 references noise limits by space type, typically in NR (Noise Rating) values, with targets below NR40 for patient areas and even lower in recovery or neonatal zones.
Common pitfalls include:
- Omitting attenuators in plantrooms located adjacent to wards
- Underestimating regeneration noise from thermal wheels
- Selecting fan types or control strategies that increase low-frequency hum
- Failing to model duct-borne sound transmission, especially in modular risers
HTM-compliant systems must achieve both design-stage prediction and site-measured acoustic performance during validation.
- Non-Compliant Controls or Alarm Integration
Control systems for HTM-critical spaces must do more than operate fans and dampers—they must actively safeguard clinical environments. Non-compliances include:
- Absence of alarms for fan failure, filter pressure drop, or system deviation
- Lack of interlocks for HEPA filter monitoring or negative pressure alarms
- No provision for safe-mode operation during BMS or sensor failure
- Failure to simulate fault conditions during commissioning to verify safety response
Infection control and estates teams often identify these control gaps too late, delaying sign-off or triggering system redesign.
- Incomplete Documentation at Handover
As outlined in the documentation section, handover is a regulated milestone, not just a formality. Systems may be rejected where:
- O&M documentation is generic or not site-specific
- Commissioning reports lack key readings or are unsigned
- Filter certification is missing or mismatched to specification
- Validation test results are incomplete, especially in UCV or isolation zones
Trusts increasingly require documentation audits before clinical use is permitted. A compliant handover pack is critical for regulatory assurance and lifecycle traceability.
Final Observation:
These risks are not merely technical—they represent breakdowns in project governance, communication, and regulatory alignment. Consistent involvement from Authorising Engineers, commissioning managers, and infection control stakeholders is essential to avoid non-compliance. Early technical submittals, mock-up reviews, and phased validations should be used to reduce risk before handover.
What are HTM 03 01 derogations, and when are they appropriate?
In the context of healthcare ventilation, a derogation is a formal, documented exemption from one or more specific requirements of HTM 03 01. Derogations are not a loophole or a shortcut—they are a risk-managed exception process used only when full compliance is technically unachievable, financially disproportionate, or would introduce greater operational risk.
HTM 03 01 is recognised by NHS England and UK healthcare regulators as the de facto compliance benchmark for ventilation design, installation, and maintenance. However, it is also understood that legacy estates—especially those in constrained urban settings or housed within ageing infrastructure—cannot always implement full compliance without major structural disruption or impact on clinical service continuity.
In such cases, a derogation may be proposed and signed off, typically under the authority of the Authorising Engineer (Ventilation) and Trust-level Estates or Infection Control leadership.
Examples of typical derogations include:
- Restricted access provision: AHU sections that cannot meet the HTM-prescribed 1,000 mm service clearance due to immovable plantroom constraints, but where risk is mitigated via removable panels, lighting upgrades, or scheduled downtime.
- Reduced air change rates: Temporary repurposing of rooms (e.g. outpatient spaces used for higher-risk procedures) where mechanical systems cannot be immediately upgraded. Risk is offset via increased cleaning, supplemental air purification, or strict scheduling.
- Non-standard airflow configurations: Inability to implement full fresh air and extract in smaller treatment or diagnostics rooms, mitigated through HEPA-filtered recirculation or hybrid systems with enhanced filtration.
- Partial component compliance: Use of otherwise compliant AHUs that lack specific HTM features—such as dual fans or IP65-rated casings—in situations where immediate replacement is infeasible, but compensatory monitoring or lifecycle replacement plans are implemented.
The derogation process includes:
- Risk Assessment: A formal evaluation of the room’s clinical function, occupancy profile, and deviation from HTM is conducted. This considers infection control implications, ventilation efficacy, and any adverse consequence of inaction.
- Documentation: A derogation statement or matrix is completed. This records the specific HTM clause, the nature of non-compliance, mitigating measures, and proposed remedial actions. It must be traceable and version-controlled.
- Authorisation: Sign-off is typically required from the Authorised Person (Ventilation) and, where necessary, the Infection Prevention and Control (IPC) lead or Ventilation Safety Group (VSG).
- Time-Bounding and Review: Derogations must be time-limited or included in a wider estate lifecycle plan. Some are condition-based (e.g. contingent on low-risk occupancy), while others are tied to capital upgrade timelines.
Important Notes:
- Patient safety is non-negotiable. No derogation can be permitted if it introduces unmanageable risk to patient or staff welfare.
- Derogations are subject to audit. The CQC, NHS Improvement, and Trust Clinical Governance teams may request evidence of risk management, mitigation, and review.
- Recordkeeping is mandatory. All derogations must be retained in the site’s compliance file, with logs of validation, inspection, or agreed compensatory controls.
Mansfield Pollard’s design and compliance teams work closely with Trust estates departments and M&E consultants to minimise derogation needs through early-stage space planning, modularised plant integration, and adaptable AHU design. Where unavoidable, we support derogation framing, alternative compliance analysis, and design remediation planning to ensure alignment with HTM 03 01’s intent and regulatory expectations.
How are existing ventilation systems managed under Part B for refurbishments and lifecycle planning?
HTM 03 01 Part B is specifically designed to support the ongoing management, maintenance, and compliance of existing ventilation systems in healthcare settings. While Part A outlines the technical standards for new-builds and major refurbishments, Part B acknowledges the realities of legacy infrastructure and provides a structured governance model for maintaining safety and performance across the system lifecycle.
Many NHS Trusts operate buildings with plantrooms, ductwork, or AHUs installed decades ago, predating the current HTM framework. Part B offers a mechanism for aligning such systems with contemporary performance and infection control requirements, without demanding immediate replacement where this is technically or economically unfeasible.
Key Lifecycle and Compliance Strategies Under Part B:
- Risk Assessment-Based Prioritisation: Part B mandates that ventilation systems be categorised according to their clinical function and risk exposure. High-dependency areas such as theatres, isolation rooms, and critical care units must receive prioritised attention. Where compliance gaps are identified, these should inform phased upgrade plans or interim mitigations.
- Routine Revalidation and Condition Surveys: HTM 03 01 Part B Clause 6.5 requires systems in high-risk areas to undergo annual revalidation. This includes airflow checks, pressure differential measurements, and filtration integrity testing. Medium-risk areas may be tested less frequently, but inspection cycles must be determined via formal risk assessment.
- Maintenance and Inspection Records: Detailed records of inspections, validations, and remedial works must be maintained. Part B sets out documentation expectations, including logbooks, filter change logs, and evidence of microbial or dust control where applicable. These records must be auditable and retained for review by NHS Authorising Engineers and regulatory inspectors.
- Phased Refurbishment and Upgrade Planning: Trusts are expected to develop medium- to long-term strategies for bringing non-compliant systems up to modern standards. This may include modular AHU replacements, introduction of HEPA filtration, installation of new access routes, or BMS upgrades. Lifecycle planning should be costed and prioritised according to estate risk profiles.
- Use of Derogations Where Justified: Where full compliance cannot be immediately achieved, HTM 03 01 Part B permits the use of formal derogations. These must be supported by robust risk assessments, signed off by the Authorising Engineer (Ventilation), and documented as part of the Trust’s compliance and maintenance strategy. The derogation must also define any interim controls or compensations in place.
- Monitoring for Change of Use: If a room’s clinical function changes—such as converting an outpatient space into a minor procedure room—Part B requires that the ventilation system be reassessed for compliance against its new risk category. Refurbishments or repurposing that alter room occupancy, clinical exposure, or ventilation demand will often trigger revalidation or reconfiguration obligations.
This structured framework ensures that even where full HTM 03 01 Part A compliance is not achievable, Trusts can maintain safe operational conditions, reduce infection risks, and transparently demonstrate control of ventilation-related hazards. Over time, Part B enables strategic convergence toward full regulatory alignment without requiring wholesale replacement of functioning legacy assets.
How does HTM 03 01 support Sustainability and Net Zero Targets?
Although HTM 03 01 is primarily a technical compliance framework for clinical safety, it also plays a critical supporting role in delivering the NHS Net Zero targets. Ventilation systems represent a substantial proportion of energy consumption in acute healthcare facilities, and even marginal inefficiencies can translate into significant environmental and financial costs. As a result, HTM 03 01 embeds sustainability measures within its performance, control, and maintenance requirements.
The memorandum does not replace specialist sustainability standards or carbon reporting frameworks, but it ensures that all ventilation systems specified and operated within healthcare premises meet foundational energy performance expectations. These standards, when fully implemented, deliver measurable reductions in carbon emissions, operational energy use, and whole-life cost.
Key Sustainability-Linked Features in HTM 03 01:
- Fan Efficiency and SFP Targets: HTM 03 01 requires air handling units to comply with BS EN 13053, which includes Specific Fan Power (SFP) limits consistent with Ecodesign Regulation (EU) 2016/2281. Low SFP values indicate efficient fan and motor combinations, and HTM encourages the use of EC plug fans, VSDs, and fan arrays that maintain redundancy without compromising part-load efficiency.
- Heat Recovery and Thermal Efficiency: Where compatible with infection control, HTM 03 01 supports the use of energy recovery systems such as thermal wheels, run-around coils, or plate heat exchangers. The design must ensure that recovered energy does not introduce cross-contamination risk — for example, extract-side HEPA filtration is often required in critical areas. Properly integrated heat recovery significantly reduces heating and cooling loads across the year.
- Smart Controls and Occupancy-Linked Operation: All systems must be capable of interfacing with Building Management Systems (BMS). HTM mandates zoning, time control, and variable-speed operation to match ventilation rates with room occupancy and clinical schedules. In theatres and isolation suites, setback modes or standby ventilation can deliver energy savings during non-use periods, provided pressure and filtration requirements remain met.
- Lifecycle Efficiency Through Maintenance Protocols: One of the most overlooked sustainability benefits of HTM 03 01 is its rigorous approach to maintenance and revalidation. Systems with clogged filters, unbalanced flow, or failing dampers consume far more energy than necessary. The requirement for periodic testing, clear access, and detailed O&M documentation ensures that AHUs perform close to their design efficiency throughout their operational life.
- Support for Low-Carbon Technology Integration: HTM-compliant AHUs are increasingly being specified with integrated low-carbon enhancements, including air source heat pumps (ASHP), thermal batteries, and BMS-linked environmental sensors. While not explicitly required by HTM, the standard provides a regulatory foundation on which more advanced sustainability technologies can be safely and compliantly layered.
Strategic Implications:
For NHS Trusts and design teams working toward the Greener NHS agenda, HTM 03 01 should be seen not as a barrier to sustainability but as a foundation. By embedding good ventilation practice, it prevents energy waste, supports predictable performance benchmarking, and reduces the risk of retrofit inefficiencies. Projects that go beyond the baseline — adopting ultra-low SFP fans, enhanced insulation classes, and intelligent airflow control — can realise both carbon savings and improved clinical resilience.
What are the energy efficiency expectations for HTM 03-01-compliant ventilation systems?
HTM 03-01 does not define energy performance as a standalone objective, but it embeds energy efficiency into its core mechanical and hygienic requirements. In healthcare ventilation, where systems often operate 24/7 and serve high-risk clinical environments, reducing energy consumption without compromising infection control or compliance is both a technical challenge and a statutory responsibility under the NHS Net Zero agenda.
Energy efficiency in context: not optional, but integrated
Under Part A of HTM 03-01, several system attributes directly influence energy performance:
- Fan selection and SFP limits: While HTM 03-01 does not stipulate a Specific Fan Power (SFP) threshold, it requires fans to be selected for low noise and efficient operation, with preference given to EC plug fans and direct-drive motors. These allow for N+1 redundancy, reduced turbulence, and optimised airflow profiles. Typical HTM-compliant systems target SFP values ≤1.8 W/(l/s), depending on duty.
- Heat recovery expectations: High-efficiency thermal wheels, plate heat exchangers, or run-around coils are widely used to reduce energy demand from heating and cooling. These systems must exceed 70% efficiency while maintaining strict airflow segregation to prevent cross-contamination.
- Low-leakage casing: BS EN 1886 casing class L1 (leakage), T2 (thermal transmittance), and TB2 (thermal bridging) are functionally required by HTM to prevent energy loss and condensation. Casing leakage increases fan load and bypasses airflow control, compromising both hygiene and energy performance.
- Demand-based control: While constant volume is still used in some critical systems, HTM-compliant AHUs can incorporate variable speed drives (VSDs), demand-controlled ventilation (DCV), and room-level sensors—provided these are verified through commissioning and alarmed for fail conditions. These systems dramatically reduce energy usage during low-occupancy periods.
NHS Net Zero Carbon alignment
In support of the NHS’s Delivering a Net Zero Health Service (2020) plan, most Trusts now set energy efficiency as a project objective alongside HTM compliance. Framework specifications may call for:
- Verified SFP and heat recovery values
- Lifecycle carbon assessments (embodied + operational)
- Integration with estate-level BMS and energy dashboards
- Design modelling using TM54 and TM65 methodologies
What are the commissioning and validation steps for HTM 03 01-compliant ventilation?
Commissioning and validation are fundamental to achieving full HTM 03 01 compliance. While design and installation establish the system’s physical and functional framework, it is through rigorous performance testing, documentation, and independent verification that compliance is proven. These steps ensure that critical parameters — including air change rates, pressure regimes, filtration integrity, and hygiene standards — are fully met before the system is approved for clinical use.
HTM 03 01 treats commissioning and validation not as technical formalities but as clinical safeguards. Errors or omissions at this stage can directly compromise infection control and patient safety.
Commissioning Requirements
Commissioning is the process of setting the system to work and verifying that it performs to design intent. Under HTM 03 01, this includes:
- Airflow Measurement and Balancing
Supply and extract airflow rates must be measured at terminal grilles and balanced across all rooms to achieve design-specified ACH values. Particular attention must be given to critical zones such as theatres and isolation rooms. - Pressure Regime Verification
Pressure differentials between adjacent rooms must be established and confirmed using calibrated differential manometers. For example:- +10 Pa between operating theatre and anaesthetic room
- –5 Pa to –10 Pa in negative pressure isolation rooms
- Filter Performance Confirmation
- Initial pressure drop across all filter stages must be recorded
- HEPA filters (if present) must be tested for correct fitment and airflow distribution
- All filters must be installed in a manner that permits safe, tool-free removal and seal integrity
- Fan and Motor Testing
- Fan direction, speed control, redundancy switch-over (if applicable), and vibration levels must be confirmed
- Anti-vibration mounts and acoustic isolation must be checked against specification
- Controls and Alarm Checks
- Functional testing of dampers, temperature control loops, and humidity regulation
- Alarm verification for fan failure, filter differential pressure, and system faults
- Integration with the Building Management System (BMS) including override functionality and setpoint visibility
- Thermal and Acoustic Verification
- In temperature-sensitive areas such as theatres and neonatal units, verify that supply air temperature and humidity ranges are met under load
- Where required, noise levels must be measured and compared with HTM-specified NR (Noise Rating) limits
Commissioning must be carried out by qualified engineers, witnessed by the project’s Authorised Person (Ventilation), and fully documented in commissioning records for inclusion in the final handover pack.
Validation Process
Validation is the formal verification that the commissioned system delivers safe and effective performance under real or simulated operational conditions. It is generally carried out by an independent engineer appointed by the Trust’s Authorising Engineer (Ventilation).
Key validation activities include:
- Air Change Rate Testing (ACH)
Confirmed at each terminal and calculated for every room where ACH is specified under HTM 03 01 Part A (e.g. ≥25 ACH in UCV theatres) - Room Pressure Mapping
Continuous or stepped testing using calibrated pressure sensors, with graphical or tabular output to confirm correct directional airflow - HEPA Filter Integrity Testing
- Where terminal HEPA filters are used, a DOP or PAO challenge test is required (per ISO 14644-3)
- Filters must be challenged using an appropriate test aerosol, and leakage must fall within defined acceptance thresholds
- Microbiological Testing
In ultra-clean or aseptic environments, validation may include:- Surface swabbing
- Airborne particle counting (e.g. to ISO Class 5 or EU GMP Grade A standards)
- Agar plate sampling
- Noise Verification
- NR levels must be confirmed in occupied areas such as wards, recovery rooms, and theatres
- Equipment-generated noise and regenerated noise from ductwork are both considered
- Control System Functional Testing
- Validation under failure scenarios (e.g. power outage, sensor failure) to confirm system safety and fail-safes
Documentation and Sign-Off
The final step is the production of a complete validation report. This forms part of the system’s compliance record and must include:
- All test results, including raw data and calculated values
- Calibrated instrument certificates
- Authorised sign-off from the Validation Engineer and AP(V)
- Recommendations for revalidation frequency (typically annual for critical care areas)
Ongoing Requirements
Validation is not a one-off task. HTM 03 01 mandates:
- Annual revalidation for operating theatres, UCV suites, and isolation rooms
- Routine performance checks aligned with the maintenance regime
- Revalidation after any modification, filter replacement, or fan upgrade
Failure to complete commissioning and validation to HTM 03 01 standards — even where the physical installation meets the specification — renders the system non-compliant and unfit for clinical occupation.
How is ongoing verification and maintenance managed in HTM 03 01 environments?
HTM 03 01 makes clear that compliance is not achieved at commissioning alone — it must be sustained throughout the lifecycle of the ventilation system. This requires structured, risk-based maintenance and verification to ensure continued performance, hygiene, and regulatory integrity.
Part B of HTM 03 01 specifically addresses operational and maintenance protocols, particularly for existing systems in live healthcare settings. These measures are essential not just for compliance, but for patient safety, infection control, and asset longevity.
Core Maintenance and Verification Regime
Ongoing management is defined by both time-based intervals and risk stratification. High-dependency zones — such as theatres, isolation suites, and critical care areas — require more frequent checks and revalidation.
Typical HTM-aligned maintenance protocols include:
- Daily / Weekly Checks (by on-site maintenance personnel)
- Visual inspection of ventilation status via BMS or local panel
- Check of fan operation, filter differential pressure indicators, and temperature/humidity sensors
- Alarm status confirmation (e.g. fan failure, pressure loss, system fault)
- Monthly / Quarterly Checks
- Physical inspection of access doors, filters, dampers, and visible ductwork
- Lubrication or functional check of moving parts (fans, dampers, actuators)
- Verification of environmental parameters (room temperatures, humidity, basic airflow checks)
- Annual Revalidation (or more frequently in high-risk areas)
- Airflow balancing and confirmation of ACH at all terminal points
- Pressure regime testing between critical rooms
- HEPA filter integrity testing (where applicable) using DOP or PAO challenge
- Review and revalidation of BMS functionality, alarms, and system failsafes
- Acoustic testing and microbiological sampling (if specified)
Authorised Person (Ventilation) Oversight
All ongoing maintenance and verification must be conducted under the supervision of an appointed AP(V). This individual is responsible for:
- Approving the maintenance strategy and schedule
- Ensuring contractors and staff are appropriately trained
- Reviewing maintenance records and exception reports
- Authorising derogations or remedial works if compliance is compromised
HTM Documentation Requirements
HTM 03 01 requires full traceability for all maintenance activity. This includes:
- Maintenance logbooks (digital or physical)
- Service visit reports and test certificates
- Exception logs (e.g. failed filter test, fan motor fault)
- Asset registers detailing each system’s service history
- A documented escalation process for critical faults
These records must be retained for inspection by CQC, NHSI, and Trust internal audit teams. Incomplete or inconsistent documentation is a common cause of non-compliance during external audits.
Integration with SFG20 and PPM Strategies
Most Trusts integrate HTM 03 01 obligations into a broader Planned Preventative Maintenance (PPM) regime based on SFG20 standards. This allows harmonisation of tasks, resource planning, and cost forecasting while maintaining HTM-specific critical controls.
In HTM environments, maintenance is not just an operational function — it is a clinical safety requirement. Failure to maintain and validate ventilation systems not only breaches statutory duty but places patients and staff at risk.
How can modern AHUs be designed to exceed HTM 03 01 minimums?
HTM 03 01 sets the minimum performance threshold for ventilation systems in healthcare environments — but exceeding these requirements can yield measurable benefits in operational efficiency, clinical safety, environmental performance, and future-proofing.
Progressive NHS Trusts, M&E consultants, and design authorising engineers are increasingly specifying AHUs that outperform HTM minimums to support sustainability targets, reduce lifecycle cost, and enhance patient and staff outcomes.
Key Design Enhancements Beyond HTM Compliance
- Energy-Optimised Fan and Motor Systems
- EC plug fans with variable-speed control and N+1 redundancy reduce Specific Fan Power (SFP) while maintaining resilience.
- High-efficiency motors (IE4/IE5-rated) reduce electrical consumption, particularly during part-load operation.
- Demand-controlled ventilation (DCV) algorithms adjust airflow based on occupancy or IAQ sensors.
- Advanced Casing and Panel Integrity
- L1 casing leakage and D1 strength class as standard per BS EN 1886 improve hygienic performance and reduce infiltration.
- Thermal bridging minimised through TB1/TB2-rated panels and integrated insulation.
- Smooth, sealed internal finishes exceed HTM cleanability requirements, supporting infection control and faster cleaning turnaround.
- High-Efficiency Heat Recovery
- Energy recovery systems with >70% efficiency, such as:
- Thermal wheels with purge sectors to prevent cross-contamination
- Plate heat exchangers with bypass dampers and frost protection
- Smart heat recovery control to optimise efficiency while meeting hygiene constraints
- Where HTM exemptions apply (e.g. exhaust from isolation), dual coil systems or energy loop configurations may be used
- Energy recovery systems with >70% efficiency, such as:
- Integrated Acoustic Control
- Internally mounted silencers and acoustic splitters reduce footprint while achieving NR targets
- Vibration isolators, fan balancing, and sound-attenuated casings address HTM 03 01 acoustic requirements in sensitive areas such as recovery wards and NICUs
- Smart Control and BMS Integration
- Native BMS integration with BACnet or Modbus protocols for full system visibility
- Real-time monitoring of filter pressure, fan performance, and temperature/humidity levels
- Predictive maintenance alerts and energy analytics via cloud-enabled platforms
- Modular and Skid-Mounted Construction
- Factory-assembled modular systems reduce installation time and on-site disruption
- Skid-mounting simplifies retrofits in constrained plantrooms or rooftop installations
- Improves build quality and allows FAT testing before delivery
Strategic Benefits of Exceeding HTM Minimums
- Resilience: Over-compliant systems offer greater uptime, particularly in theatres, isolation rooms, and critical care zones.
- Sustainability: Enhanced SFP, reduced leakage, and high-efficiency heat recovery contribute directly to NHS Net Zero commitments.
- Operational Cost: Lower energy use and easier maintenance translate to long-term savings.
Audit Preparedness: Systems with headroom over minimum HTM thresholds are less likely to trigger compliance flags during CQC or NHSI audits.
How does HTM 03 01 compare with European ventilation standards?
HTM 03‑01 is a uniquely stringent standard tailored for the UK’s National Health Service, yet it exists within a wider ecosystem of European ventilation regulations and best practices. Understanding how it compares with these can help specifiers working across borders or adapting non-UK systems to NHS requirements.
HTM 03‑01 vs BS EN 13053 and BS EN 1886
BS EN 13053 defines the performance of central air handling units, including airflow, heat recovery, fan efficiency, and filter classification. BS EN 1886 focuses on mechanical characteristics like casing strength, thermal transmittance, and air leakage.
HTM 03‑01 mandates compliance with both standards but layers additional clinical requirements on top. For example:
- HTM stipulates L2 casing leakage as the minimum but recommends L1 for theatres and critical care. EN 1886 classifies L1 as the highest level of leakage control.
- Filter configurations under HTM include F7 pre-filters and HEPA-grade final filters, whereas EN 13053 only references generic filter classes without prescribing specific healthcare applications.
- Fan redundancy and fail-safe control strategies are a requirement under HTM for critical zones, but not explicitly addressed in either EN standard.
HTM 03‑01 vs DIN 1946-4 (Germany)
DIN 1946-4 is the closest European analogue to HTM 03‑01. It governs ventilation in healthcare buildings in Germany and includes detailed requirements for:
- Room classification based on infection risk
- Supply and extract pressure hierarchies
- Minimum ACH (Air Changes per Hour)
- Filter classes (typically ePM1 or H13/H14)
However, HTM 03‑01 is generally considered more prescriptive in terms of:
- Mandatory Authorising Engineer roles
- Documented validation and revalidation cycles
- Specific acoustic and access design guidelines
- Integration with UK BMS and electrical compliance (e.g. BS 7671)
HTM 03‑01 vs REHVA Guidelines (Europe-wide)
REHVA (Federation of European Heating, Ventilation and Air Conditioning Associations) publishes guidance for hospital ventilation, including COVID-related updates. Their approach tends to be more flexible and research-informed, but not enforceable as regulation.
REHVA guidelines emphasise:
- Room airflow patterns for infection prevention
- Ventilation system types (displacement, mixing)
- Considerations for natural and hybrid ventilation
HTM 03‑01, by contrast, demands mechanical ventilation throughout, with explicit performance validation and risk mitigation strategies.
Summary
| Aspect | HTM 03‑01 | BS EN 13053 / 1886 | DIN 1946‑4 | REHVA Guidelines |
| Legal Status | Mandatory for NHS | Supporting technical standards | National regulation (Germany) | Voluntary guidance |
| Infection Control | Core focus | Not specified | Strong focus | Thematic |
| Validation Required | Yes | No | Yes | No |
| Revalidation Cycle | Mandated (e.g. annual) | Not covered | Project-specific | Not covered |
| Fan Redundancy | Required in critical zones | Not addressed | Optional | Not addressed |
For NHS healthcare projects, HTM 03‑01 always takes precedence. However, understanding the nuances of European standards can assist in multi-country procurement, product compatibility assessments, and performance benchmarking, especially for global manufacturers or Trusts considering international best practice.
What are the acoustic design implications of HTM 03 01?
Acoustic performance is a critical but often underestimated aspect of hospital ventilation design. HTM 03 01 places explicit and non-negotiable emphasis on noise control—not for comfort, but as a functional requirement that supports clinical outcomes, patient recovery, and operational clarity. This makes acoustic specification significantly more stringent than in commercial or industrial HVAC projects.
Noise level limits by space type
HTM 03 01 Part A Annex B sets out maximum internal noise levels (typically expressed as NR or dB(A)) for different healthcare environments. For example:
- Single-bed wards: ≤35 dB(A)
- Operating theatres: ≤45 dB(A)
- Consultation rooms: ≤40 dB(A)
- Critical care areas: ≤40 dB(A)
These values represent ambient noise levels with ventilation systems operational and are measured in accordance with BS EN ISO 16032. The limits apply under both daytime and night-time conditions in most clinical settings.
Design challenges for AHU and ductwork systems
Meeting these targets places significant constraints on both equipment specification and system layout. Air handling units (AHUs) intended for HTM-compliant environments must incorporate:
- Low-noise EC fan arrays with optimised impellers and low rotational speeds
- Attenuators tailored to fan-specific frequency spectra, sized to avoid regeneration
- Vibration isolation mounts to decouple plant noise from building structure
- Controlled duct velocities—typically ≤4 m/s in main ducts and ≤2.5 m/s at terminals—to prevent turbulence
- Strategic plantroom placement, with acoustic lobbies or buffer zones between noisy equipment and occupied areas
Breakout noise from ductwork must be addressed via in-line attenuators, acoustic lining, or architectural barriers. Additionally, casing breakout from AHUs—particularly those on roofs above sensitive spaces—must be considered and mitigated. In most NHS settings, internal fibrous linings are prohibited in clinical air paths; acoustic treatments must therefore be hygienic, cleanable, and HTM-compliant.
Casing sound power performance
While HTM 03 01 does not mandate specific casing sound power thresholds, specifiers routinely require performance verification to BS EN 1886 and ISO 3744/3746. Manufacturers should supply octave band data for acoustic modelling and validation. In areas with adjacent sleeping or recovery zones, casing noise must be modelled using worst-case load assumptions and included in the acoustic risk assessment.
Acoustic documentation and verification
HTM-compliant projects may require:
- Acoustic modelling reports to compare predicted and actual noise levels
- Site validation using calibrated sound level meters
- Independent verification by a qualified acoustic consultant
- Documentation that links attenuation, breakout control, and plantroom layout to HTM 03 01 Annex B requirements
Where target levels cannot be met using standard equipment, the specification must be escalated to include architectural intervention or spatial redesign. Retrofitting acoustic mitigation into completed systems is rarely effective.
Why acoustic compliance matters
In healthcare, sound is not just a comfort issue—it is a clinical performance factor. Excessive ambient noise is associated with:
- Slower patient recovery and disrupted sleep cycles
- Increased clinician fatigue and cognitive load
- Miscommunication in critical care and surgical zones
- NHS Trust policy breaches and reputational risk
Acoustic non-compliance can lead to project delays, contract disputes, and enforced rework. For this reason, acoustic design must be embedded from RIBA Stage 2, verified during factory acceptance testing (FAT) where feasible, and validated on-site before clinical handover.
What are the most common HTM 03 01 compliance pitfalls, and how can they be avoided?
Even with the best intentions, ventilation systems designed for HTM 03 01 compliance frequently fall short due to overlooked details, incorrect assumptions, or incomplete coordination between stakeholders. These issues often result in failed validations, costly rework, or delayed clinical use—making proactive avoidance essential.
- Inadequate Maintenance Access
One of the most common failures is insufficient access for inspection and servicing. HTM 03 01 mandates clear physical access to all serviceable components, including filters, coils, fans, dampers, and drainage systems. This includes side-hinged doors, ≥1 metre of clear working space, lighting, and safe floor surfaces. Yet in constrained plantrooms—especially during refurbishments—designers may compromise on layout, door swing, or internal service access.
This is not a soft failure; lack of access is a validation-critical issue. It must be resolved early through coordinated design involving the AHU manufacturer, mechanical consultant, and contractor. All access routes must be documented and verified during commissioning.
- Non-Compliant Filter Specification
HTM 03 01 mandates at least two stages of filtration—typically G4 or ISO Coarse 70% as prefilters, followed by F7 or higher (ISO ePM1 ≥ 65%) final filters. HEPA filtration (H13/H14 to EN 1822) is required for high-risk zones such as operating theatres or isolation rooms.
Common errors include specifying only one stage, omitting HEPA where needed, or proposing bag filters without proper housings. To avoid these, always align filter grades with the functional risk zone and ensure housing design prevents bypass, supports visual inspection, and allows pressure drop monitoring.
- Incorrect Casing Leakage Class
HTM 03 01 does not specify casing leakage explicitly but requires integrity suitable for infection control. BS EN 1886 Class L2 is considered the minimum acceptable standard for healthcare AHUs. However, some manufacturers offer L3 as default, which risks excessive leakage, reduced airflow performance, and poor pressure stability.
Always specify L2 minimum, request manufacturer certification, and verify during FAT. Where casing is situated above occupied areas, breakout and condensate integrity must also be confirmed.
- Acoustic Oversights
HTM 03 01 defines maximum noise levels for clinical spaces (e.g. ≤35 dB(A) for wards), but does not dictate casing or fan limits directly. This leads to missed criteria during AHU specification—especially in retrofits or when fan walls are used.
Design teams must calculate full-path acoustic levels including ductwork, terminal devices, and room contribution. AHUs should be equipped with silencers or low-noise fans, and breakout levels validated in octave bands. Acoustic compliance must be checked at commissioning and recorded in the validation file.
- Control Strategy Deficiencies
Many off-the-shelf AHU control systems fail to meet HTM expectations. Part A requires integration with BMS, alarm signalling, fail-safe operation, and override capability for clinical clearance.
Frequent faults include lack of airflow failure alarms, inability to detect pressure loss, or no auto-changeover for redundant fans. To avoid this, controls should be specified with input from HTM-experienced engineers and tested during Site Acceptance Testing (SAT).
- Misuse of Non-HTM Standards
Finally, a common but dangerous error is assuming that compliance with standards such as BS EN 13053, ISO 16890, or Eurovent is equivalent to HTM 03 01. While these form the foundation for many technical classifications, they do not address clinical risk, governance, or validation protocols.
HTM 03 01 must be treated as the primary standard for healthcare ventilation in the UK. All supporting standards must be subordinate to its clinical and operational requirements.
What do NHS Trusts expect in practice, beyond what’s written in HTM 03 01?
While HTM 03 01 defines the national regulatory baseline for clinical ventilation, NHS Trusts frequently impose additional expectations that reflect operational experience, legacy infrastructure, and site-specific risk management. These Trust-level interpretations are often the deciding factor in whether a system is accepted, commissioned, or delayed.
For instance, Estates Teams may enforce stricter rules on access clearance than those stated in the Memorandum, based on historical incidents with coil cleaning, filter replacement, or fan isolation. A design that meets the dimensional minimums of HTM 03 01 may still be rejected if it fails local practical standards—particularly in hospitals with limited plantroom space or constrained servicing regimes.
Documentation expectations also vary significantly. Some Trusts require full O&M manuals, commissioning packs, and product certification (e.g. filter class verification, fan performance curves) prior to delivery, not just at handover. Others insist on witnessing Factory Acceptance Tests (FATs) or receiving pre-approval of technical submittals, including BIM models and control schematics. These are not HTM-mandated but are embedded in Trust procurement and governance workflows.
Several Trusts also require formal “HTM Compliance Statements” or labelled documentation for audit purposes. These internal checklists, sometimes referred to as “HTM badges”, are used to demonstrate that each design element has been validated against local policy and statutory guidance. Failure to supply them—even if the underlying design is sound—can delay approval.
Noise criteria represent another domain of local discretion. While HTM 03 01 provides NR values for space types, some Trusts impose tighter acoustic tolerances, especially in paediatrics, oncology, and mental health settings. An AHU that is acoustically acceptable for a general ward may be rejected for a vulnerable care unit unless pre-approved noise calculations and octave band data are submitted.
here are also preferences around BMS integration, component sourcing, and service continuity. Some Trusts mandate compatibility with existing controls architecture or require AHUs to be built around familiar spares profiles. In others, infection control teams may reject units that include non-standard drainage arrangements, internal insulation methods, or atypical fan arrays—even where technically compliant.
Ultimately, Trusts are not just users—they are risk holders. Estates Managers, Authorising Engineers, and infection control leads are accountable for safety, compliance, and operational reliability. The most successful HTM 03 01 projects are those where technical compliance is accompanied by clear stakeholder dialogue, early engagement, and evidence that local requirements have been understood and integrated—not assumed or retrofitted.
How should air handling units be drained in accordance with HTM 03-01?
HTM 03-01 Part A requires that all air handling units in healthcare environments are fitted with drainage systems designed for hygienic operation, safe maintenance, and compliance with infection control protocols. This applies particularly to systems with cooling coils, humidifiers or other components where condensate is generated during normal use.
Drain pans must be positively sloped, typically at a gradient of 1:80, to ensure complete and uninterrupted condensate flow toward the outlet. Flat or poorly pitched pans can result in stagnant water, increasing the risk of microbial growth and non-compliance with COSHH. The drain outlet must discharge into a trapped and easily accessible tundish. If the condensate volume is significant, such as from large cooling coils, the drainage system should incorporate a sump sized for maximum expected flow, with provision for overflow detection where required.
Wherever possible, drain components should also conform to BS EN 13053, which classifies the performance of AHU internal components including coil drainage, filter access, and cleanability.
Mansfield Pollard AHUs are supplied with pre-sloped stainless steel drain pans, smooth internal finishes and integrated condensate discharge pipework, all designed to meet or exceed HTM 03-01 drainage criteria. For external installations, this drainage provision is extended into maintenance corridors or external weather enclosures to allow year-round access and servicing under safe and hygienic conditions.
Who is responsible for ventilation system governance under HTM 03-01?
HTM 03-01 Part B defines a formal governance structure to ensure that ventilation systems in healthcare environments are designed, commissioned, operated, and maintained in accordance with clinical safety principles and legal compliance. This structure is built around clearly designated roles, each with defined responsibilities and accountability.
Every NHS Trust or healthcare provider must adopt a written ventilation safety policy, approved at Board or Estates level, that sets out how these governance responsibilities are allocated. At its core, this policy must identify and formally appoint the following personnel:
Authorising Engineer (Ventilation) [AE(V)]:
An independent and impartial expert, the AE(V) is responsible for advising the Trust on compliance with HTM 03-01, reviewing designs, validating commissioning evidence, and leading investigations into failures or non-compliance. The AE(V) chairs the Ventilation Safety Group (VSG) and acts as the highest technical authority on ventilation matters within the organisation.
Authorised Person (Ventilation) [AP(V)]:
Typically an in-house estates engineer or facilities manager, the AP(V) is responsible for the day-to-day operation, inspection, and maintenance of ventilation systems. They coordinate routine validation, manage maintenance contracts, and serve as the operational link between clinical teams, infection prevention leads, and contractors. The AP(V) must maintain system documentation, schedule inspections, and ensure that all work is carried out by competent personnel.
Competent Person (Ventilation) [CP(V)]:
A trained and qualified engineer or technician, the CP(V) carries out defined technical tasks—such as filter changes, duct cleaning, commissioning support, or disinfection—under the supervision of the AP(V). The CP(V) must demonstrate competence in HTM 03-01 practices, typically through accredited training and ongoing experience.
These roles are supported by additional governance structures, including:
- Ventilation Safety Group (VSG): A multidisciplinary governance body convened to review commissioning reports, approve derogations, manage revalidation cycles, and oversee ongoing compliance.
- Designated Person (Ventilation): Sometimes a Board-level estates lead, this role ensures that policy, resources, and personnel structures are in place to implement HTM 03-01 across the Trust.
All appointments must be formally recorded in writing, with scope of responsibility, reporting lines, and escalation protocols clearly defined. Governance structures must also align with statutory electrical safety frameworks (e.g. BS 7671) and Health and Safety at Work legislation, especially where AHU access, control interfaces, or confined spaces are concerned.
How often must HTM 03-01 ventilation systems be revalidated and inspected?
HTM 03-01 Part B sets out a mandatory programme of inspection, verification, and revalidation for ventilation systems serving clinical environments. This ensures that performance, hygiene, and safety remain consistent with the original commissioning intent and that critical infrastructure continues to support infection control.
Minimum Verification Frequency
At minimum, all systems must undergo an annual verification to assess:
- Visual condition of plant and ductwork, including signs of damage, leakage, or contamination
- Measured airflow and pressure performance compared to design and commissioning values
- Filter performance, including pressure drop measurements and physical inspection for seal integrity
- Temperature and humidity control (where applicable to clinical function)
- Microbiological sampling in high-risk areas, such as ultra-clean operating theatres or isolation rooms, where specified by infection control policy or Authorising Engineer (Ventilation)
Enhanced Revalidation Requirements
Some systems require more frequent or detailed validation:
- Ultra-clean ventilation (UCV) theatres typically require six-monthly validation, including particle counts and canopy airflow testing
- Negative or positive pressure isolation rooms must be pressure-tested every 6 to 12 months, depending on clinical risk and recent performance history
- Critical care areas may require bespoke intervals, determined by the Ventilation Safety Group (VSG)
All revalidation activities must be carried out by a Competent Person (CP[V]), witnessed or reviewed by an Authorised Person (Ventilation) [AP(V)], and reported to the Ventilation Safety Group. Where systems fail to meet validation criteria, they must be taken out of clinical use or formally risk assessed with temporary mitigation agreed.
Acoustic Testing
Where acoustic performance forms part of the original commissioning specification—such as in recovery wards, mental health units, or paediatric spaces—in-situ sound pressure level testing should be repeated during annual revalidation. Acceptable methods include ISO 3744 (precision measurements) or ISO 3746 (engineering grade), with results benchmarked against original NR or dBA targets.
What are the COSHH and inspection requirements for AHU drainage systems?
Under HTM 03-01 Part B and the wider Control of Substances Hazardous to Health (COSHH) Regulations 2002, healthcare ventilation systems must be maintained in a manner that prevents the accumulation and release of biological contaminants. Drainage systems, particularly in air handling units incorporating cooling coils or humidifiers, are a key area of focus.
All condensate drain points must be inspected regularly to confirm that pans are free-draining, traps are functional, and there is no standing water that could promote microbial growth. Inadequate drainage can lead to bacterial colonisation, aerosol formation, or cross-contamination through recirculated air. These are not only compliance breaches under HTM 03-01 but also COSHH-reportable risks.
HTM 03-01 requires that these inspections be formally documented, and that cleaning or disinfection be carried out as necessary. In systems serving high-risk areas, such as operating theatres or critical care, this may include microbial testing of condensate or pan surfaces. Records must be retained and made available to the Authorising Engineer (Ventilation) and infection control personnel.
Mansfield Pollard AHUs are configured to ensure full drainage access, with sloped pans, stainless steel finishes, and dedicated maintenance corridor integration where required. These features support compliant inspection and reduce the likelihood of retained water, satisfying both HTM 03-01 and COSHH obligations
How does Mansfield Pollard ensure HTM 03 01 compliance?
At Mansfield Pollard, HTM 03 01 compliance is embedded in every stage of our healthcare ventilation process, from design and specification to manufacture, testing, and handover. We don’t retrofit HTM principles into standard AHUs, we build dedicated healthcare units with HTM requirements as the baseline, not the upgrade.
Here’s how we deliver full, auditable compliance:
- Purpose-Built HTM-Compliant AHUs
Our healthcare AHUs are designed specifically to meet the detailed mechanical, hygienic, and control requirements of HTM 03 01 Part A. This includes:
• Dual-stage filtration (G4 + F7) as standard, with options for H13/HEPA upgrades
• Smooth internal surfaces for cleanability
• Sloped drain pans beneath wet coils
• 100% removable access panels and full-size access doors
• Fan redundancy and run/fail indication for resilience in critical care environments
All designs are validated against the latest HTM 03 01 and BS EN 13053/1886 standards. - HTM-Aware Design Process
We work closely with M&E consultants and NHS Authorising Engineers at early design stages to pre-empt compliance issues:
• Every HTM AHU has a dedicated General Arrangement (GA) drawing with access zones clearly marked
• Component spacing is reviewed for service clearance and manual handling
• Filter change pathways, door swing radii, and maintenance access are visualised in 3D models where needed
This avoids costly redesigns or rejection at the FAT/SAT stage. - Optional Full FAT & SAT Compliance Testing
We provide full Factory Acceptance Testing (FAT) and Site Acceptance Testing (SAT) services, which include:
• Airflow verification
• Filter seal integrity checks
• Control logic and alarm testing
• Casing leakage tests (BS EN 1886)
• Acoustic and vibration analysis (ISO 3744/14694)
These are witnessed and documented in a format aligned with HTM compliance and NHS audit processes. - HTM-Compliant Documentation Packs
Our handover documentation exceeds the minimum NHS Trust requirements and includes:
• O&M manuals customised to each AHU
• Filter and maintenance schedules
• As-built CAD drawings and wiring schematics
• Acoustic reports
• FAT/SAT test certificates
• Compliance declarations mapped to HTM 03 01 paragraphs
This makes commissioning, audit, and long-term maintenance smoother for estates teams. - Support from Project to Operation
We maintain involvement through:
• Design meetings and BMS interface support
• Factory witness testing
• Commissioning handover support
Where can I find HTM-compliant AHUs and support resources?
Specifying a ventilation system for healthcare is high-stakes work. The regulatory environment is complex, the risks are critical, and the expectations are rightly high. This makes the choice of AHU manufacturer — and their understanding of HTM 03‑01 — one of the most important decisions in a project.
Mansfield Pollard is a proven partner to NHS Trusts, consultants, and contractors across the UK. Our HTM-compliant AHUs are in active service in hospitals, specialist treatment centres, and critical care environments — each supported by detailed compliance documentation, FAT/SAT procedures, and a commitment to lifecycle performance.
We offer:
- Dedicated HTM-compliant AHU ranges
- Factory acceptance testing aligned to healthcare project requirements
- Customised O&M manuals and NHS-compliant handover packs
- Support at every stage — from design to post-installation training
For full technical support, design consultation, or to book a CPD on HTM 03‑01 ventilation compliance, contact our healthcare ventilation specialists or visit mansfieldpollard.co.uk.
